Clairview & Stanage Bay microgrid feasibility study
We’re investigating innovative solutions to energise Queensland’s remote and regional communities in our Community Microgrid Feasibility Study.
The study will investigate how innovative technologies, using solar energy and battery storage integrated with smart communications devices, can improve the reliability of electricity supply to remote and regional communities at the fringe of Queensland’s electricity network.
With the support of the Australian Government, through the Regional and Remote Communities Reliability Fund (RRCRF), the study will allow us to:
- Test different technologies
- Determine the feasibility of establishing microgrids to improve network reliability and resilience
- Identify the best solutions to energise some of Queensland’s remote and regional communities.
By advancing our ability to integrate renewable energy into our energy systems, the study will also support Queensland’s journey to net zero emissions.
Where is the study located?
The Central Queensland coastal towns of Clairview and Stanage Bay will be the focus of this exciting study. These small coastal ‘fringe of grid’ communities are located at the end of the ‘Northern’ electricity feeder, which at over 1,000 kilometres, is one of our longest powerlines.
The design of the ‘Northern’ feeder, incorporating both three-phase and Single Wire Earth Return (SWER) construction in a ‘fringe of grid’ location, makes the two communities an ideal choice for the study. The different construction designs in close proximity will allow us to explore how different microgrid technologies can be applied in different situations.
To find out more about these locations, please read our Clairview Community Profile (PDF 485.5 kb) and our Stanage Bay Community Profile (PDF 535.4 kb).
To find out more about the study please see our Frequently Asked Questions below.
Want to know more or be involved?
If you’re a Clairview or Stanage Bay community member, we want your voice as part of this study. If you’re a stakeholder, you can keep up to date and provide feedback on the study through the following information.
Newsletters
Download our newsletters to find out more.
- Project Newsletter - March 2024 (PDF 817.9 kb)
- Project Newsletter - August 2022 (PDF 799.5 kb)
- Project Announcement Flyer - April 2022 (PDF 225.9 kb)
Subscribe for updates
Subscribe for updates and select ‘Community Microgrid Feasibility Study’ in the Major Project drop down list. And you can add in ‘Keep me updated’ in the Your Feedback section.
Any personal information we collect about you will only be used and disclosed by us in accordance with our Privacy Statement.
Videos
0:02 / 1:37 Microgrid Feasibility Study Project - Introduction Video
Skip to descriptionMy name’s Sophie Allen and I’m the Project Engineer Western Grid. We’re here today in Stanage Bay, which is a small community at the end of a long SWER line in Central Queensland.
Stanage Bay is typical of many ‘fringe of grid’ communities. Not all fringe of grid communities are in outback western Queensland. Many are along our coast including island communities.
Hey, I’m Jake Anderson, Microgrid Projects Engineer, here at Stanage Bay where we are doing a feasibility study looking at which innovative technologies we can use to integrate into our remote communities, such as this one, to complement the existing power supply here.
The Microgrid Feasibility Study is investigating a range of smart technologies like solar power, battery storage systems and state-of-the-art control systems, which together create microgrids.
When there is a fault on the electricity network a microgrid can provide an alternate power supply until the fault is fixed.
Our project is investigating the feasibility of a range of different technical solutions for small isolated and remote communities, just like Clairview and Stanage Bay.
Over the coming months, we’ll share how our feasibility study is progressing. So why not visit our project web page where you can find out more about the project and register for updates.
Watch our Microgrid feasibility study - Introduction project video to learn more about our project to investigate the feasibility of a community microgrid in Clairview and Stanage Bay.
Microgrid Feasibility Study Project – Get Ready for Storm Season
Skip to descriptionHere at Ergon, we’re playing a key role in providing secure, affordable, and sustainable energy solutions for our customers right across Queensland.
Through more than 200,000 kilometres of powerlines, our electricity distribution network, supplies power to millions of Queenslanders, some of whom live in the state’s harshest and most remote locations.
When you think of remote communities, you might typically think of towns in outback Queensland, but we also serve several isolated island and coastal communities, like Clairview and Stanage Bay, where we are currently conducting a Community Microgrid Feasibility Study.
Supplying electricity to these remote and regional communities does come with a range of challenges – especially over the summer months when severe storms, cyclones, flooding, and bush fires can affect the area and disrupt the power supply.
Even when the weather is picture perfect, part of what makes these communities such beautiful places to live – trees and wildlife – also increases the risk of unplanned outages.
With our remote and isolated communities generally located at the end of long stretches of powerlines, often in hard-to-reach locations, it can be challenging for our crews to access the network, and find and fix faults when they occur. Roads into communities can be flooded or washed out, leaving communities without power for some time.
That’s why our Community Microgrid Feasibility Study is investigating innovative ways to integrate smart technologies into the electricity network, improving reliability and the resilience of fringe of grid communities - just like Clairview and Stanage Bay .
The study will help us to identify how a microgrid might supply these small communities, by tapping into locally generated and stored power, to keep the lights on and the drinks cold, while our crew’s access, find and fix faults on the main network.
Our crews are ready to respond. But with a severe weather season forecast by the Bureau of Meteorology, it’s time for our communities to get ready too.
So, it’s time to know your risks. Register for and stay tuned to alerts and warnings. Check that your emergency kit is fully stocked and keep informed on power outages through our outage finder.
And remember, if you see fallen powerlines, always assume that they are live, stay well away, call 000 or Ergon and wait in a safe place for our crews to respond.
Stay say and don’t forget to keep an eye out for the next Microgrid Feasibility Study update via our project website.
Our Microgrid feasibility study project - Get ready for storm season video explains some of the impacts the network may face that may delay power restoration in rural, remote and isolated areas like Stanage Bay and Clairview.
MEet Stanage Bay store owner Maree Haynes
Skip to descriptionHi, I'm Kate from Ergon Energy.
I'm working on Ergon's Community Microgrid Feasibility Study Project. As part of the project I was lucky enough to visit the beautiful township of Stanage Bay, which is an isolated coastal community in Central Queensland.
Whilst there I met Maree Haynes - a local and business owner of the Plumtree Store and had a chat to Maree about the electricity supply and the importance of it for a small, isolated community like Stanage Bay.
Hi, I'm Maree Haynes from Plumtree Store at Stanage Bay. We've been here roughly 28 years. We do have this small business here caters for anything from petrol, gas, food. We get in fresh bread, milk, takeaways, groceries. This is a tight-knit community here with about 45 permanent people. Your peak times of Easter and Christmas, you probably could have even up to a thousand just local people in their houses and their visitors and family. Some of the houses here actually rent as well so we do have an influx of people coming to enjoy Stanage for its fishing and crabbing.
Stanage Bay is such an isolated community and your population experiences massive seasonal growth.
The whole community needs electricity - it does get stretched at times. We do have quite a few outages, low volts. It's just not a very large power supply. It is hard. It is good to have a fully power supply all the time. We're probably different to other areas where you can just go and buy a fridge and freezer. We've got to be careful with what electrical gear we do buy. When you buy bain-maries and cookers and things like that. it's got to be single phase because it is only a single phase wire that comes in here so a good steady flow of power would be awesome.
Maree, Plumtree Store is central to the Stanage Bay community.
We do have solar put on now because our power was at a stretch, our power bill was quite exy as we have lots of fridges and things like that which do consume quite a lot of power.
So, Ergon's Microgrid Feasibility Study is trying to find ways to improve the resilience of the electricity supply to remote communities like Stanage Bay.
Solar is great, it's been the best thing since sliced bread. If there's any other avenues that you can go to to get better power usage I think it would be great. Less power outages would be awesome.
Thanks, Maree for chatting with us today about the power supply to Stanage Bay. We think less power outages would be awesome, too, so that's why we're conducting the Microgrid Feasibility Study.
We talk to a local business owner about the challenges of being at the end of a 100km powerline as Ergon investigates the feasibility of microgrids in remote communities.
Simulating community microgrids
Skip to descriptionHey, I m Jake Anderson, Microgrid Project Engineer, and I'm leading the Clairview and Stanage Bay Community Microgrid Feasibility Study.
Today, I m going to take you behind the scenes at our Microgrid and Isolated Systems Test Facility - or MIST where we are going to meet some of the people, and look at the products they're testing, as part of our Clairview and Stanage Bay Microgrid Feasibility Study.
Let's go take a look!
Hi, welcome to the MIST facility in Cairns.
So here we can do integration of multiple devices and test them in a controlled environment. This allows us to be able to test things like diesel generators, battery systems, solar, potentially hydrogen fuel cells, to stress test the equipment, so it's safe to deploy.
This is Dave our Product Integration Technical Officer. Dave has been busy setting up the testing of the inverter and battery systems that we are using for the feasibility study. Each individual battery has to be tested before they are installed in the racks and connected to the rest of the technology in the MIST.
Speaking of simulations, let's go meet Mitch and find out more about the Real Time Digital Simulator or RTDS. So as part of the MIST facility we have our supercomputer which allows us to recreate real world electrical networks and simulate things like big solar and batteries which may be connected to those networks.
Yeah, so behind me we have our big battery inside a shipping container. As you can see it s made up of a bunch of smaller batteries strung together. As part of our microgrid study we will use this battery system along with some solar that we have on the roof and a simulated load and use that basically to simulate a community microgrid. This battery will be able to supply a community when the main network is down. Because the energy needs of our remote communities are different, and the space available in these communities is often limited, here in the Innovation Lab we're looking at residential and commercial solar systems.
Setting up these small solar and battery systems in a microgrid arrangement may hold the key to improving the energy supply in some of our remote communities.
These simulations help us replicate Clairview and Stanage Bay's electrical networks in our simulated world, so that we can see how the solar, batteries and communications equipment might perform under various network conditions. There's lots of options available for our engineers as they are designing microgrids. These simulations help us to work out which option is the most viable solution. So, upgrading our network in the field can be quite expensive. That's why we want to test this stuff in the laboratory, so we can make sure we get the right solution for our network and our customers.
We're in the final stages of the project. When our testing and modelling is complete, we'll make recommendations on how to improve the reliability of our 3-phase and SWER networks.
I hope that you've enjoyed this behind-the-scenes tour of our MIST facility.
Key project information
We want to investigate alternate technologies, incorporating solar energy and battery storage to improve network performance, reliability, and resilience for ‘fringe of grid’ communities.
These communities, located at the edges of the electricity network, can experience more frequent and longer outages due to the length of the powerlines, several environmental factors, as well as the disadvantage of distance when responding to unplanned outages.
Many of our fringe of grid lines were designed in the 1960’s and 1980’s to serve the small communities of that time. While they continue to serve these communities well, electricity needs have changed over time. We are increasingly reliant on electricity in every facet of our lives, and in recent years, the take up of renewable energy has grown.
These factors all need to be considered by our network planners when designing the right solutions for each community’s electricity needs.
Before we start making changes to how we operate the network, we want to make sure we have the right solutions. By understanding the community’s electricity needs, how much, and when it is needed, we can design and test the most efficient network solution.
Because building electricity networks is expensive, and the assets are in place for a long time, we want to get it right and the Community Microgrid Feasibility Study will provide us with that opportunity.
The Community Microgrid Feasibility Study will investigate opportunities to improve the reliability and quality of power supply at Clairview and Stanage Bay for both the three-phase and SWER networks.
The aim of the study is to determine how a microgrid could automate seamless switching between the grid and island mode when needed, using smart grid controls and local distributed energy resources, to ensure a reliable energy supply. It will also explore the benefits of using the local energy resources for grid support in times of need while grid connected.
Diesel generation is used in some areas to support our networks in our remote communities. This project will investigate how distributed renewable energy technologies, such as roof top solar and battery storage can:
- improve reliability of supply to these communities
- offer an alternative to costly network expansion
- improve environmental outcomes by limiting the use of diesel generation.

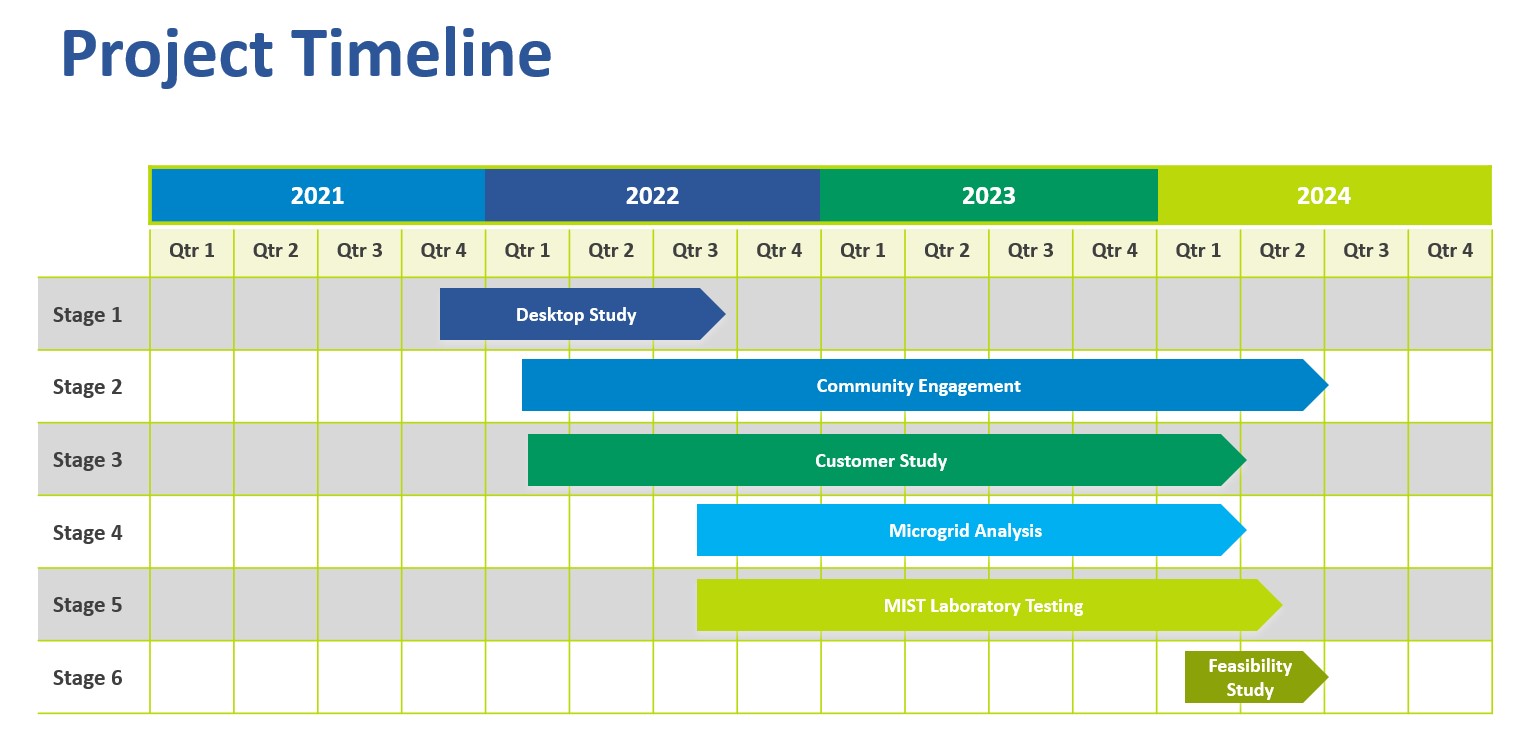

The project will involve several elements, delivered in six stages.
Stage 1 – Network Desktop Study
We will conduct a series of technical studies to analyse the existing network and electricity supply to these two communities and research available information from established network microgrids. We will look at new technologies being used around the world and consider their suitability on our remote ends of the network.
Stage 2 – Council, Community and Customer Engagement
Our community engagement will involve a range of activities including sitting down with Councils and the community to explain the project, introducing some energy literacy education, and working together on some of the options for the project. We’ll also provide project updates and publish the final study findings.
Stage 3 – Customer Energy Use Study
In this stage, we will get to know the Clairview and Stanage Bay communities and their energy needs in more depth. We will install new digital metering, conduct energy audits and conduct a land assessment to identify a list of potential sites suitable for establishing a microgrid close to the network.
Stage 4 – Microgrid Technical Analysis
This stage will involve a range of technical assessments focussing on how a microgrid would interact with the electricity network. We will look at the fundamentals for intelligent microgrid operations including control and communications, safety and protection, and ways to ensure stability in the system and obtain dynamic operational response.
Stage 5 – MIST Laboratory Prototype and Testing
This exciting stage involves creating microgrid prototypes in the MIST lab and simulating how these systems would operate. The team in the MIST will develop and run an extensive range of tests to see how the microgrids would operate and respond in a range of ‘real life’ scenarios.
Stage 6 – Community Microgrid Feasibility Study
This stage involves compiling all of the information that we have learned through the microgrid feasibility study and compiling a report outlining the findings. The report will explain feasible microgrid options and include a deployment plan for decision makers.
The project commenced in late 2021 when we secured funding and established a small project team. The study will be completed by mid 2024 and will be delivered in six stages as follows:
- Desktop study – Nov 2021 to Sep 2022
- Community engagement – Mar 2022 to Jun 2024
- Customer energy use study – Mar 2022 to Mar 2024
- Microgrid analysis – Sep 2022 to Mar 2024
- MIST laboratory testing – Sep 2022 to May 2024
- Feasibility study – Feb 2024 to Jun 2024.
The objectives of the Community Microgrid Feasibility Study include:
- Determine the technical and financial feasibility of installing microgrids at the communities of Clairview and Stanage Bay and use the lessons learnt for other fringe of grid locations
- Understand customers’ energy needs and their interest and willingness to be involved in a future microgrid solution
- Develop business intelligence to include microgrids as a feasible option for addressing network constraints such as reliability, power quality or capacity, as an alternative to expensive network expansions.
This study will make a vital contribution towards the Queensland Government’s 50% renewable energy target, and the state’s journey to net zero emissions by advancing our knowledge on the integration of renewable energy into our energy systems. It will also support the evolution of ‘renewable energy’ microgrids to improve the performance of the network.
Queenslanders are putting solar on homes and businesses at record rates, with almost 40% of detached houses, and over 10% of businesses across Queensland, now with rooftop solar energy – that’s well over a million rooftops!
We expect Queenslanders to double the amount of solar connected to the electricity network by 2030. We support the transition to renewable sources of energy and this study is one of many initiatives we have underway to get the network ready for this expected increase.
The small coastal towns of Clairview and Stanage Bay are ‘fringe of grid’ communities located at the end of one of Queensland’s longest powerlines, measuring over 1,000 kilometres in length.
The communities have many similarities including location and size, and they are connected to the same feeder powerline. However, the design of infrastructure supplying the two towns is very different.
The electricity network here is unique in that Clairview is supplied by the three-phase network, and Stanage Bay by a Single Wire Earth Return (SWER) construction.
This different network design combination in a fringe of grid location makes these communities ideal for our study, as it will highlight the similarities and differences in using microgrids integrated with the different network construction.
The Microgrid and Isolated Systems Test (MIST) facility is an energy laboratory, located in Cairns, where we can research new energy technologies before introducing them to the network. The MIST allows us to accelerate the integration of new technology into the electricity network.
The MIST boasts a super-computer for real time digital simulation, as well as a large array of connection options, allowing complex testing of technology in simulated conditions.
This will allow us to identify the most feasible microgrid technology to power our remote communities, saving time and money, as well as giving us confidence that the network solutions we use are fit for purpose for our fringe of grid communities.
Fringe of grid
Fringe of grid is a term that refers to parts of the electricity network that are geographically remote, located at the end of the network, often away from power generation sources and population centres.
These sections of the network have long powerlines, and are located in rural and remote areas with very few customers per kilometre.
These long powerlines may experience quality of power supply and reliability issues, and transmission losses given their distance from the generation source.
Energising communities across vast distances and in isolated locations across Queensland can be a challenge. Traditionally, the most reliable and cost-effective method of getting power to many of these regional and remote communities has been via Single Wire Earth Return (SWER) powerlines.
Our network has around 65,000 kilometres of SWER lines. It's one of the largest SWER networks in the world and supplies only 4% of our customers. The majority of the SWER network was installed in the 1970s and 1980s.
As these sections of the network age, we’re looking for more modern, innovative solutions, like microgrids, to ensure our rural and remote customers continue to have access to safe, secure, affordable, reliable, and efficient power supply into the future.
Microgrids
A microgrid is a small-scale electricity network powered by one or many distributed energy resources. They are increasingly intelligent energy systems designed to be self-sufficient and to power the electricity needs of an isolated group of customers. They can be operated either stand alone or connected to the main electricity grid.
While the technology in a microgrid can support the main electricity grid, a key benefit of the system being explored in this study, is that it could be disconnected from the main grid and operate autonomously in ‘island mode’, supplied by energy sources like solar and battery storage.
This would allow any future microgrid to operate autonomously when power supply from the main grid is disrupted or unavailable.

Not yet. This is a study using our Microgrid and Isolated Systems Test (MIST) facility to research and test different microgrid technologies in a controlled environment. We’ll use computer software to run complex scenarios and test how the equipment might operate on the network under a specific range of different conditions.
Because building electricity networks is expensive and the assets are in place for a long time, we want to get it right before we commit to making any changes to the network.
The Community Microgrid Feasibility Study will provide us with the information we need to make informed decisions about the future of the network in the area.
While one of the key benefits of a microgrid is its ability to operate independent of the main electricity grid, the study will focus on a system that remains connected to the network on a normal daily basis, but has the flexibility to be separated from the state-wide grid and operate in ‘island mode’ from time-to-time when needed.
If you are planning to build a private microgrid, there are a few things you will need to consider. Read our microgrid factsheet (PDF 591.1 kb) to find out what you need to know before you start.
Download a copy of the Frequently Asked Questions (PDF 841.8 kb) for the Community Microgrid Feasibility Study.
Our community engagement goal
We aim to provide the community with balanced and objective information to help in understanding the need for this project, our delivery approach and how it may affect people.
Our promise
We'll keep the local community informed, and we’ll acknowledge and consider any feedback.
We'll provide information in different ways including:
- project newsletters to directly affected customers and all who register for updates
- posting information on social media
- posting information on this website.
Project contact details
For more information or to provide us with feedback, please contact the project team:
Online: Project feedback form
Email: NetworkProjectEngagement@energyq.com.au
Phone: 1300 653 055
